HRA and HCRW Approval

Last updated on 25 Sep 2024

Health Research Authority (HRA) and Health and Care Research Wales (HCRW) Approval is a combined process for applying for approvals for all NHS and social care research taking place in England or Wales.

HRA and HCRW approval brings together the research ethics review and the  governance and legal review, meaning that researchers wanting to do research in England and Wales can submit one single application for the whole NHS.

Before this approval process was in place, local governance and legal checks were repeated at each place where research was going to take place.

This type of approval is different to standalone REC approval as some studies submitted for HRA and HCRW Approval do not require REC approval, and others do.

In this section we share information on how many studies were provided HRA and HCRW Approval and how long it took for applications to be reviewed.

Number of studies given HRA and HCRW Approval

Between 2018 and 2023 we saw a reduction in the number of studies given HRA and HCRW Approval, dropping from 4,694 in 2018 to 3,588 in 2023.

This reduction levelled out in 2022 and 2023, with a slight increase in 2023 to 3,588, from 3,553 in 2022.

This overall reduction is a long-term trend seen across the UK research landscape, with a move towards more large multi-site studies, rather than smaller studies at individual sites.

Another contributing factor to this reduction is a change in the eligibility criteria for student research to be reviewed by a REC.

Total number of studies receiving HRA and HCRW Approval

The total number of studies receiving HRA and HCRW Approval between 2018 and 2023 was:

  • 2018 – 4,694
  • 2019 – 4,315
  • 2020 – 3,929
  • 2021 – 3,825
  • 2022 – 3,553
  • 2023 – 3,588

Total number of studies receiving HRA and HCRW approval 2018 to 2023
Total number of studies receiving HRA and HCRW Approval 2018 to 2023 graph long description Long description

Review times

Between 2018 and 2022 the time for HRA and HCRW Approval was consistently under 100 days and slightly improved each year.

In 2023 we saw a large increase in the time taken for reviews of commercially sponsored research due to delays with the Medicines and Healthcare products Regulatory Agency issuing joint approvals.

Following a peak in June 2023 levels returned to normal and in the final quarter of 2023/2024 (January, February and March 2024) the median number of days was down to 75 days (commercially sponsored) and 65 days (non-commercially sponsored).

Our review times are now faster than pre-pandemic levels (82 days in 2018 compared to 74 days in 2023).

Number of days taken for HRA and HCRW Approval

Commercially sponsored research

Below is the median number of days taken for HRA and HCRW Approval per year for commercially sponsored research:

  • 2018 – 94 days
  • 2019 – 96 days
  • 2020 – 87 days
  • 2021 – 76 days
  • 2022 – 83 days
  • 2023 – 113 days
Non-commercially sponsored research

The median number of days taken for HRA and HCRW Approval per year for non-commercially sponsored research were:

  • 2018 – 82 days
  • 2019 – 91 days
  • 2020 – 77 days
  • 2021 – 70 days
  • 2022 – 76 days
  • 2023 – 74 days

In the chart below you can see a comparison of the time taken to review commercially sponsored and non-commercially sponsored studies submitted for HRA and HCRW Approval.

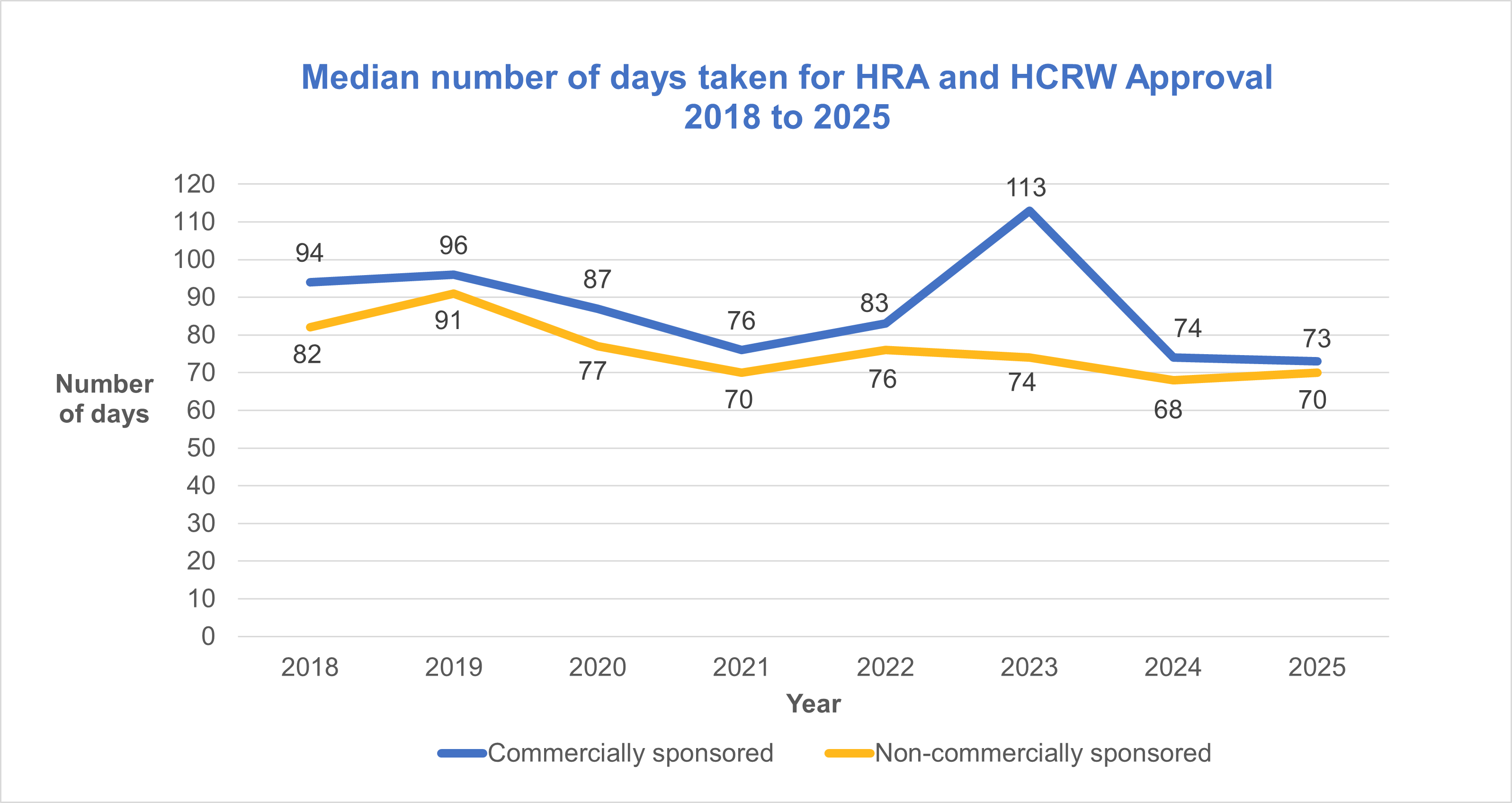

Median number of days taken for HRA and HCRW Approval 2018 to 2023
Median number of days taken for HRA and HCRW Approval 2018 to 2023 graph long description Long description

Latest review times

Between January 2024 and March 2024 (quarter four 2023/24) the median number of days for HRA and HCRW Approval was 74 days (commercially sponsored) and 65 days (non-commercially sponsored).

Between April 2024 and June 2024 (quarter one 2024/25) the median number of days for HRA and HCRW Approval was 73 days (commercially sponsored) and 66 days (non-commercially sponsored).

Quarterly breakdown of HRA and HCRW Approval review times

You can take a look at quarter-by-quarter (every three months) breakdown of HRA and HCRW Approval review times between 2018 and 2023 below:

How we break down our data

For most applicants to the Health Research Authority, the REC review forms part of the overall HRA and HCRW Approval process. A favourable opinion from a REC is also required for studies which receive support from the Confidentiality Advisory Group.

We have separated our REC review data from our HRA and HCRW Approval data because HRA and HCRW Approval applies only to the NHS in England and Wales. This approval brings together the assessment of governance and legal compliance, undertaken by dedicated HRA staff, with the independent ethical opinion by a REC so that you only need to submit one application.

Some studies submitted for HRA and HCRW Approval do not require REC approval, others do. This is explained more fully in our guidance.

We have broken down our data to reflect this difference, as well as showing timelines for HRA approval of commercial and non-commercially sponsored research.
